Overview

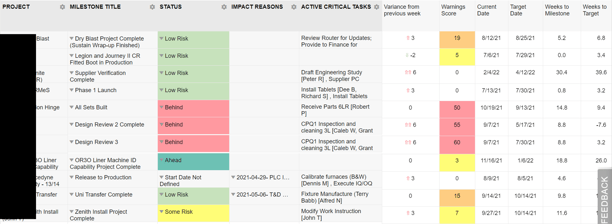

The status of projects needs to be readily available and accurate so managers know which projects are legitimately at risk and need their time and support today.
The Portfolio Milestone Table (PMT) provides exactly that information with just one click.
Column Headers
-
Project
-
Milestone Title
-
Status
-
Impact Reasons
-
Active Critical Tasks
-
Variance from Previous Week
-
Warnings Score
-
Current Date
-
Target Date
-
Weeks to Milestone
-
Weeks to Target
Project
The title of the project as defined by the Playbook Administrator.
Back to the list of Column Headers
Milestone Title
Major Milestones within a project are shown on separate rows. The title of the Major Milestone is displayed in this column and only Major Milestones are displayed.
Back to the list of Column Headers
Status

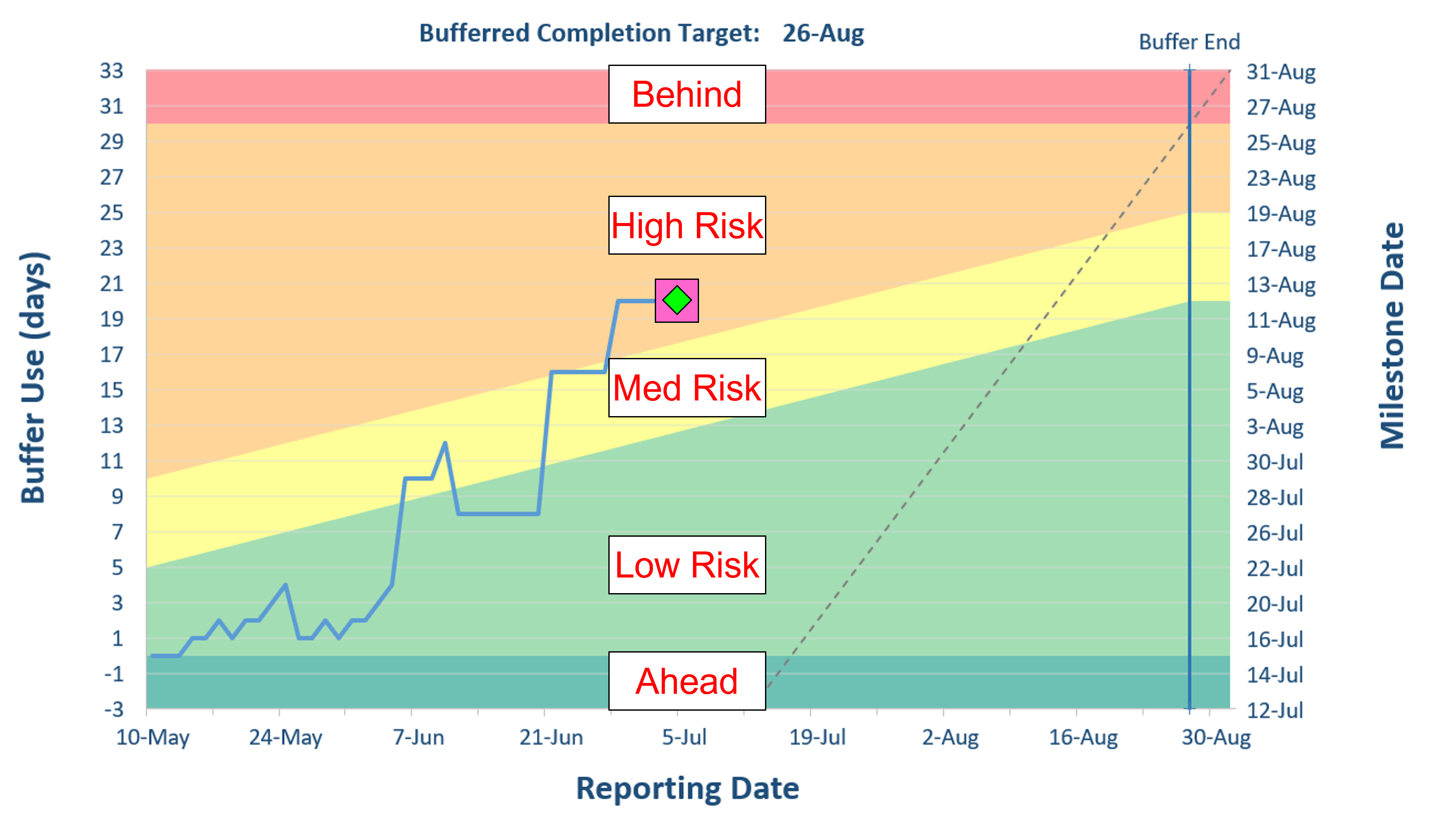

This shows the status (level of schedule risk) of the Major Milestone using the buffer chart.
For example, this Major Milestone is in the High Risk region of the buffer chart, therefore in the Status column it would say "High Risk" and be colored orange. The accuracy of the Status is also related to the Warnings Score.
Other Values:

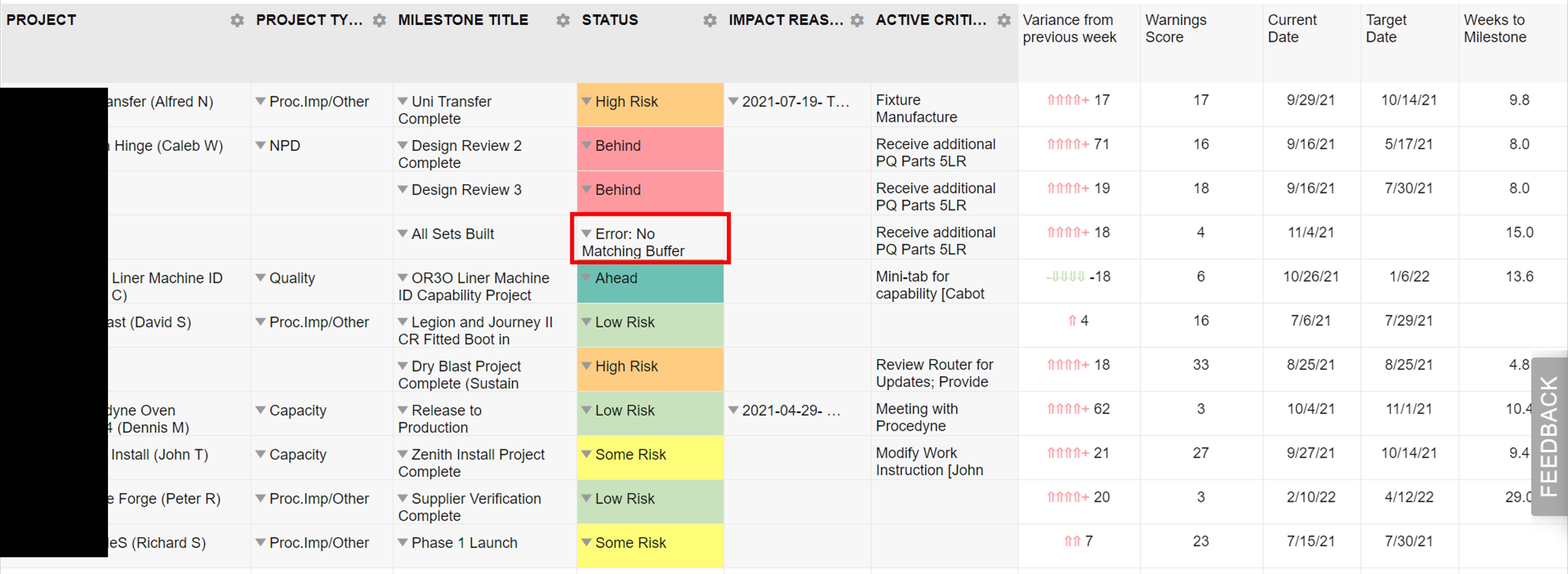

"Error: No Matching Buffer" - a buffer task is not present or not configured properly.
"Start Date Not Defined" - the Tracking Start Date is not properly defined in the buffer task.
"Not Started Yet" - the Tracking Start Date is in the future.
Back to the list of Column Headers
Impact Reasons

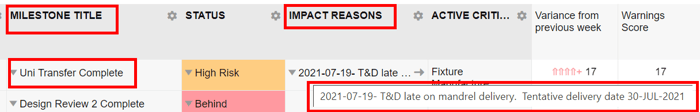

This shows the causes of delays as well as countermeasures taken to gain buffer.

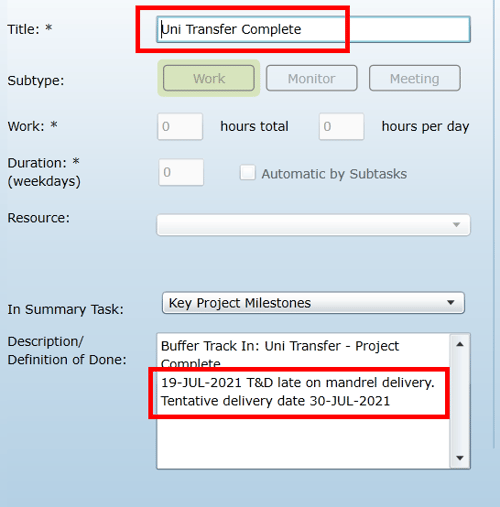

Impact Reasons are listed in the Major Milestone's Description by the Project Leader. The required format is date<space>reason with each reason on its own line (there must be a carriage return between reasons).
Back to the list of Column Headers
Active Critical Tasks
The active critical task related to activities that lead to the Major Milestone are listed in this column.
A blank indicates that a critical task is not currently being worked on which is a call to action.
Back to the list of Column Headers
Variance from Previous Week

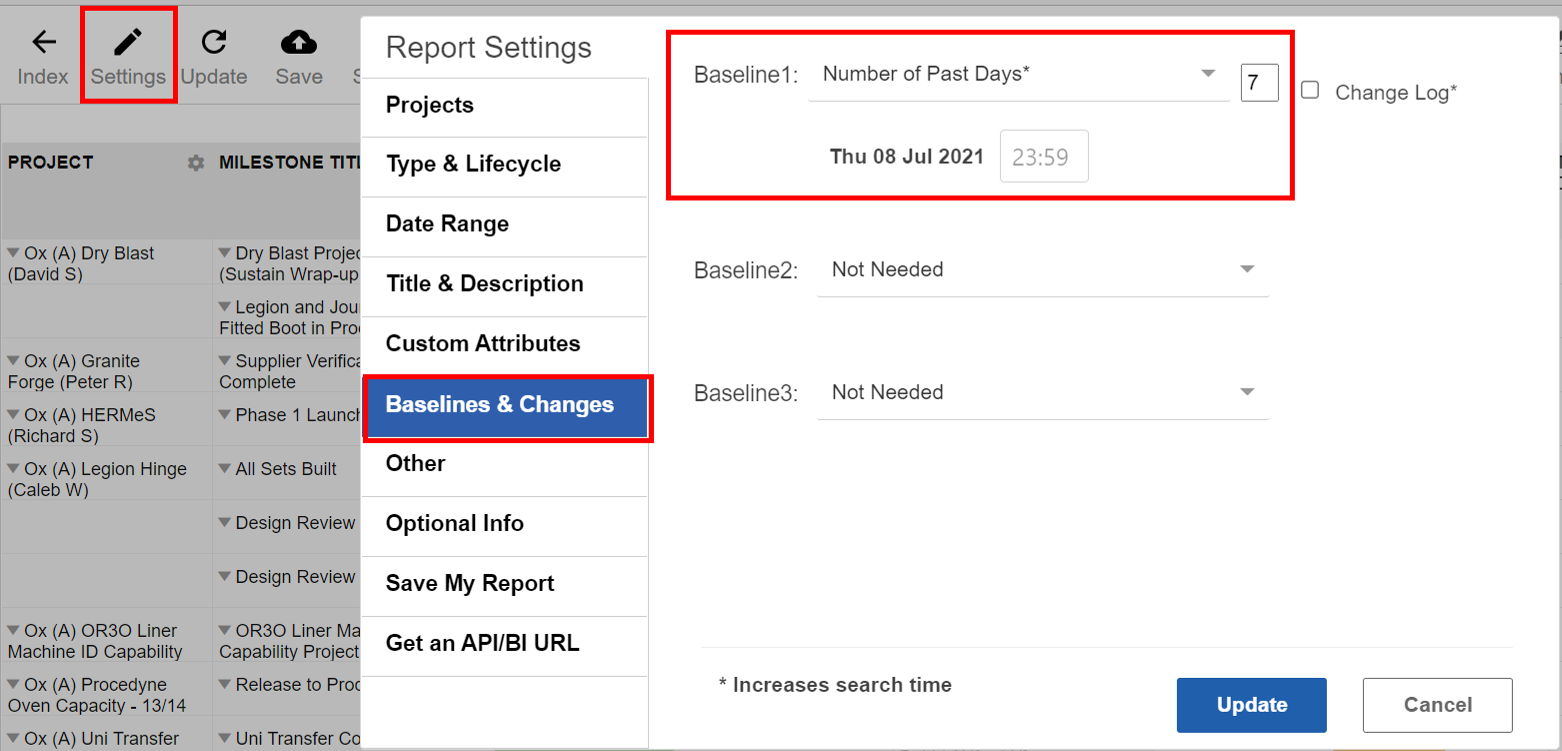

The number of weekdays the Major Milestone has moved since the Baseline 1 date.
See Baseline 1 settings in Report Settings for details.
Back to the list of Column Headers
Warnings Score
This is a quality measure of the plan leading up to the Major Milestone.
- Low scores mean the plan is up-to-date therefore you can trust the Status column.
- High scores mean the plan is not up-to-date therefore you cannot trust the Status column which is a call to action.
Warnings Score is calculated as follows...
= 1 point per out-of-date Active task + 1 point per max # of days out-of-date Active task + 1 point per out-of-date Planned task + 1 point per max # of days out-of-date Planned task + 1 point for each unlinked task + 1 point for each unassigned task.
Back to the list of Column Headers
Current Date
The Major Milestone's current date.
Back to the list of Column Headers
Target Date
The buffer task's end date.
Back to the list of Column Headers
Weeks to Milestone
The number of weeks from today to the Major Milestone.
Back to the list of Column Headers
Weeks to Target
The number of weeks from today to the end of the buffer task.
